Utilisation
Overview

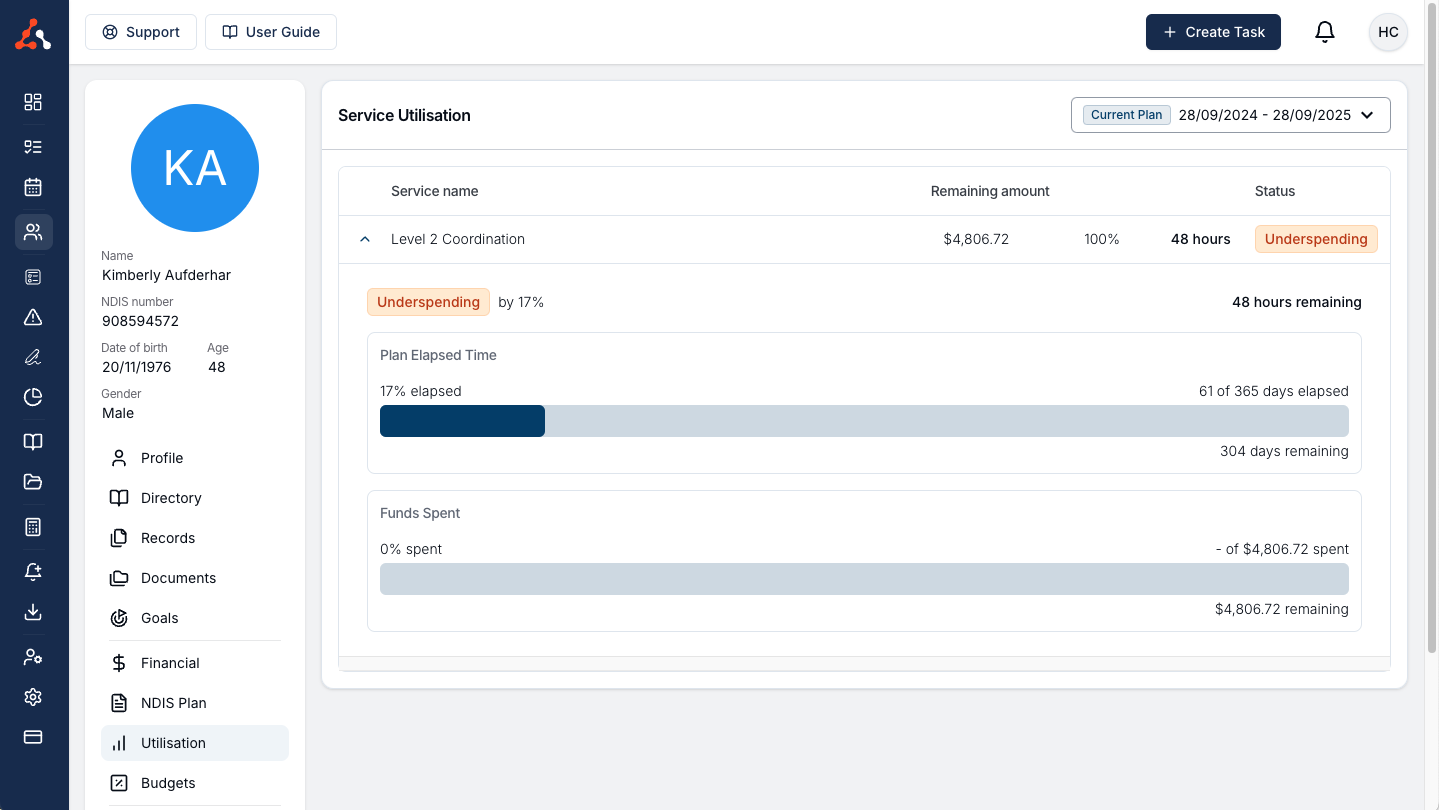

The Utilisation page within a Participant's profile shows a Funding Utilisation table for the selected Plan. Each Service row includes the remaining amount, remaining percentage, optional remaining units, and an underspending or overspending status.
Expand a Service row to view its detailed funding period or plan utilisation information, including released funds spent and any reconciliation details.
Tasks and supports show the same Services on a Funding Utilisation card, which also counts charges that are scheduled but not yet spent. See Funding Utilisation.
To learn more about organisation-wide Utilisation reporting, see the Utilisation Report.

Time and Funding Left
An expanded Service row shows how long the Service has left and how much funding is left. A figure with a dotted underline has more detail: hover over it, or click or tap it, to see it.
For a Service without a funding schedule:
- Plan Elapsed Time shows the days remaining in the Service, such as 383 days remaining. Hover over it to see roughly how many weeks that is, such as About 55 weeks. Weeks are rounded to the nearest week and only shown when 7 or more days are left.
- On the Service's end date, the days remaining read Last day. Once the end date has passed, they read Ended.
- Hover over the amount left under Spent to see about how much funding is left each week until the Service ends, such as About 2h 30m a week left until 01/11/2027.
For a Service with a funding schedule, hover over the amount spent of the amount released. As well as the percentage spent, it shows:
- How many days, and roughly how many weeks, are left in the current funding period, and the date it ends, such as 21 days (about 3 weeks) left in this funding period, until 27/11/2026. On the period's last day, it reads Last day of this funding period.
- About how much funding is left each week until the end of the current funding period, or the next one if none is current.
The weekly figure is how much more could be used each week, on average, without taking that funding period, or any later one, over. It is shown in the unit of the Charge Item chosen in Calculate remaining units using when the Service is set up, most often hours, and only appears when the Service has one and funding is left. It counts scheduled charges as well as spent ones. People who cannot view support charges see a figure that ignores scheduled charges, followed by not counting bookings.
Days are counted in your organisation's timezone. The same detail appears when you expand a row in the Utilisation Report or a Site's Utilisation tab.

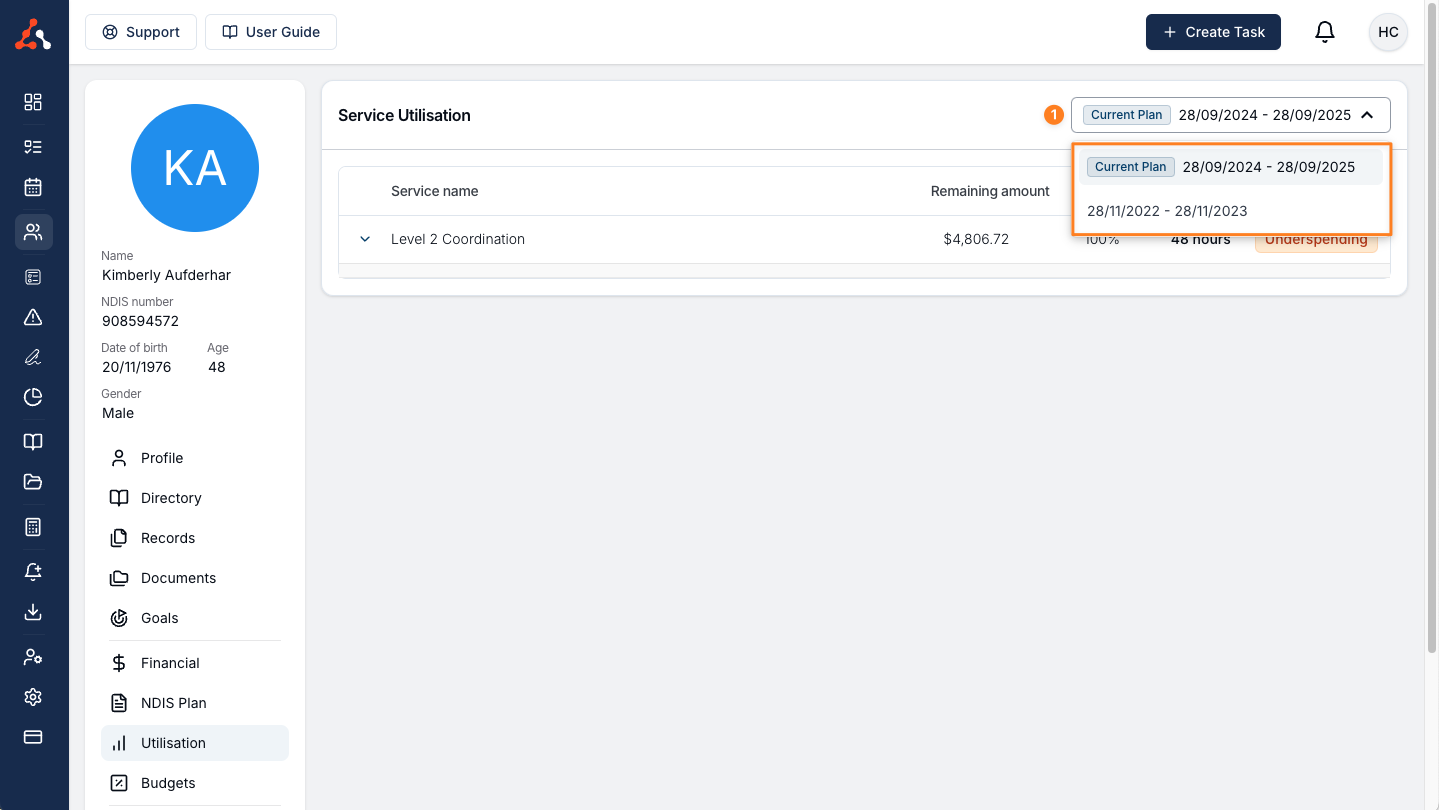

Seeing the Utilisation of a Previous Plan Period
When Plan selection is enabled for your account, use the Plan dropdown to view Utilisation for a previous Plan period.
